How to create a RACI chart

Matt Whittle

Written by Matt Whittle

Kathryn Uhles

Reviewed byÌýKathryn Uhles, MIS, MSP,ÌýDean, College of Business and IT

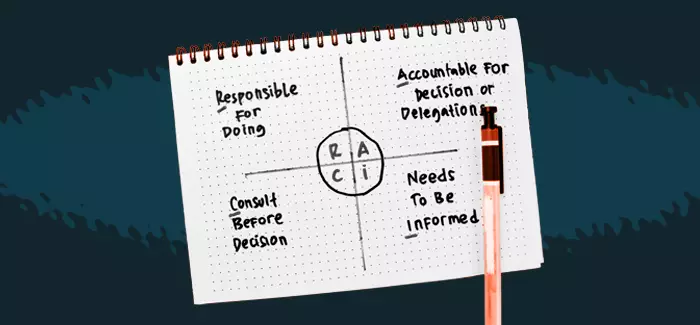

RACI chart

A RACI chart is a visual tool used in project management to assign, illustrate and communicate responsibilities to team members collaborating on projects. Here’s how to create this type of project management tool.

When is a RACI chart used?

Anyone managing a project can use a RACI chart at various stages. This management tool, also known as a RACI matrix, specifies who completes which tasks in each phase of a project and defines intended outcomes for stakeholders.

Each component of this model aligns with a different team member — Responsible, Accountable, Consulted and Informed — allowing the team to assign roles and identify when to employ this strategy during a project.

For example, a project manager can create a RACI chart at the outset of a project, which helps to define each team member’s responsibility across tasks, thereby reducing potential confusion among collaborators and stakeholders. PMs may also deploy a RACI framework midstream during a transitional phase of a project, such as restructuring, management shifts and changes in scope.

What do the RACI roles mean?

The following roles are defined in a RACI chart:

  • Responsible: This team member is designated to complete the given task from start to finish in keeping with the agreed-upon timeline. They inform other team members regarding ongoing status, roadblocks they may encounter and whether they’re remaining on schedule. Their progress affects otherÌýÌý
  • Accountable: The project manager or team lead typically assumes this role. They have the final say following the completion of a task to confirm that all requirements are adequately met. Though a team lead may assign multiple people per role for other titles in a RACI model, there is generally only one “accountable†member per task.
  • Consulted: Collaborators assigned to this role review work throughout tasks and projects, offering their expert input to guide the responsible party to the next phase of a project. These team members communicate their availability, especially to the team member completing the work, who can seek their advice.
  • Informed: These team members often do not work directly on the project at hand, but they oversee progress from a big-picture view to ensure the project is completed on time and within budget.

The chart demonstrates each phase of the project and specifies which team member occupies the responsible, accountable, consulted and informed roles for that phase. In smaller teams, some roles may overlap, requiring clear communication and documentation that indicates multiple positions.

It is critical that the accountable team member has the final say for each task, even when multiple collaborators share other RACI assignments. Having a single accountable team member can reduce the likelihood of bottlenecks in tasks and the project at large, and it assigns someone to take sole ownership of outcomes.

What are the benefits of the RACI model?

A RACI chart can provide several benefits at each stage of a project. It primarily provides clear communication regarding progress, task ownership and resource management. Each team member can identify what the project requires from them, with clear deadlines issued to all collaborators.

The tool also offers transparency by providing team members access to the chart, allowing them to remain accountable for their responsibilities while checking on completion milestones of collaborators.

Clearly communicating a project’s elements with a chart can reduce misunderstandings, which may help minimize risks throughout the process. If problems arise, the chart can allow team members to trace the origin of the issue and address it.

The singular nature of a RACI matrix provides a centralized place to handle communication rather than spreading messaging across email, direct messages and other methods. The charts also help document and track changes.

What is the process of creating a RACI chart?

Project managers can follow these steps to create a model with a RACI framework:

1.ÌýÌýÌýÌý Make a list of each required phase of the project based on the intended deliverables. The outcomes can be used to create tasks for each step.

2.ÌýÌýÌýÌý Create a list of each person who needs to be involved. The project manager should document the team member’s name and primary responsibility with the company without assigning a RACI role at this step.

3.ÌýÌýÌýÌý Designate each team member a RACI role by connecting the people from step two with tasks listed in step one: Responsible, Accountable, Consulted and Informed.

4.ÌýÌýÌýÌý Make necessary revisions after presenting the model to the team. There may be gaps with missing collaborators, overlapping roles or unassigned tasks. This phase allows the project manager to communicate with the team and finalize changes.

5.ÌýÌýÌýÌý Distribute the chart. Though changes can be made throughout the project, team members can now identify their responsibilities for each ongoing task.

Though a RACI matrix offers the opportunity for clear communication, it’s important for team members to not become over-reliant on them in lieu of direct correspondence. For example, the chart may not clearly explain the specifics of a given responsibility. In that case, relevant team members may need to talk directly to sort out the details. This can prevent inconsistent outcomes and breakdowns in communication.

For an example of what this process can look like in real life, consider a situation in which a cybersecurity company is planning to implement a new, two-factor authentication (2FA) method for its employees. The four related tasks for the project may cover:

  • Researching available forms of 2FA
  • Choosing an authentication option
  • Testing the chosen method
  • Deploying the new 2FA method

The people involved in the project could be:

  • Toni, the project manager
  • Stephan, who works in IT
  • Eddie, who assists on the cybersecurity team
  • Mercedes, who works in quality assurance
  • Kenny, who leads the cybersecurity team

For each step, the chart would designate the following positions:

Researching available forms of 2FA:

  • Responsible: Stephan
  • Accountable: Toni
  • Consulted: Eddie
  • Informed: Kenny

Choosing an authentication option:

  • Responsible: Stephan
  • Accountable: Toni
  • Consulted: Eddie
  • Informed: Kenny

Testing the chosen method:

  • Responsible: Mercedes, Stephan
  • Accountable: Toni
  • Consulted: Eddie
  • Informed: Kenny

Deploying the new 2FA method:

  • Responsible: Stephan
  • Accountable: Toni
  • Consulted: Eddie
  • Informed: Kenny

Ìý

RACI chart template

Based on the scenario above, here is a template for a RACI chart.

Ìý

Man wearing glasses and typing on laptop.

What are best practices for creating a RACI matrix?

There are several best practices to consider when creating a RACI matrix. Team leads can benefit from using a RACI template to create their charts. A template can provide consistency and clarity, which may empower other teams to also use similar frameworks. When multiple teams use the same kind of project management tools, it can help improve consistency, motivation and productivity.

Team leads can aim to ensure stakeholder involvement at the outset of a project as a best practice by clearly defining which team members will act as decision-makers. They should also create open lines of communication and encourage collaborators to track progress throughout each task. This way, as focuses and roles may shift, the leader can keep stakeholders in the loop for any changes.

Simplicity is key in creating a RACI chart. That means not adding unnecessary subtasks and ensuring that only critical responsibilities are listed.

Project management software can allow people to import their charts and connect team members to create an asynchronous workflow. Integrating a RACI matrix into software is another best practice to consider. Collaborators can then track progress for their tasks, along with other professionals’ responsibilities.
